Ravindra BagaleCourses & study guides मराठी Track your progress

Excel for Mechanical Industries: BOM, Job Cards, Maintenance and Plant Files (With Templates)

This guide is for people who work in mechanical / manufacturing and use Excel every day. You will see every common file, the formulas people actually type, and downloadable templates with made-up Indian ₹ data. Related short lessons are linked — we do not re-teach them here.

What you'll learn

  • Which roles use Excel in mechanical
  • Every common Excel file type for this industry
  • Sample tables with realistic ₹ examples (made-up names)
  • Formulas: Required qty, Efficiency %, Downtime hours, Reorder flag and more
  • Ready templates you can download and reuse

Downloads: mechanical-bom-jobcard-cost.xlsx (BOM + job cards + job cost sheet) · mechanical-production-scrap.xlsx (Daily output + scrap/rejection) · mechanical-maintenance-spares.xlsx (Breakdown log + PM schedule + spares + tool crib) · mechanical-vendor-rfq.xlsx (Vendor RFQ compare (3 vendors))

Example data only

All names, amounts, rates and dates are made up for practice. They are not real bank, insurer or plant records. Follow your organisation's own circulars and software for live work.

In short

One industry → many Excel files. Each file is one clear list. Yellow cells are inputs; green cells are formulas. Start with the Roles table, then open the matching template.

Why

Some topics already have a focused lesson. Use those for depth; use this guide for the full industry picture.

What

Chapter What it covers
Manufacturing Production Planning System Capacity, finish date and rejects in one system.
22. KPI in All Industries (Manufacturing KPIs) Short KPI list for plants.
27. 20 Industry Projects Practice projects for manufacturing.

How

  1. Skim the link if you need that one skill.
  2. Come back here for the full file list and templates.

1. Who uses Excel

Why

A plant runs on job cards, BOMs and maintenance lists. Excel is often the bridge before ERP.

What

Role Typical Excel work
Production planner Job cards, capacity, daily output.
Shop floor supervisor Production log, scrap/rejection, downtime.
Design / process engineer BOM, routing, standard time.
Maintenance technician Breakdown log, preventive schedule, spares used.
Stores / tool crib Spare parts stock, tool issue/return.
Costing / accounts Job cost sheet, material + labour + overhead.

How

  1. Read the Roles table.
  2. Open each template and name the sheet that matches your role.
  3. Related: manufacturing planning system chapter for capacity and rejects.

2. Every common Excel file

Why

If you only learn one dashboard, you miss the daily registers that feed it.

What

File What one row / sheet holds
Bill of Materials (BOM) Parent part, child part, qty per parent, UOM, scrap %.
Job card / work order Job no, part, qty, machine, start, finish, operator, status.
Machine maintenance log Machine, breakdown date, fault, downtime hours, action, cost.
Preventive maintenance schedule Machine, frequency days, last done, next due, overdue flag.
Production daily output Date, shift, part, plan qty, actual qty, efficiency %.
Scrap / rejection register Date, part, qty rejected, reason, rework or scrap.
Spare parts inventory Part no, description, min, max, stock, reorder flag.
Job cost sheet Material, labour hours × rate, overhead %, total cost per job.
Tool crib issue register Tool ID, issued to, issue date, return date, overdue.
Vendor RFQ compare Item, vendor A/B/C quote, lead time, choose lowest landed.

How

  1. Pick the file that matches your role.
  2. Download the template that contains that sheet.
  3. Replace yellow sample rows with your practice data (still made-up if you share screenshots).

3. Formulas people use

Why

Typed numbers go stale. Formulas update when inputs change.

What

Name Formula What it does
Required qty =parent_order_qty*qty_per* (1+scrap_pct) BOM explosion with scrap.
Efficiency % =actual/plan Daily output.
Downtime hours =end_time-start_time Format as [h]:mm or decimal hours.
Reorder flag =IF(stock<=min,"Reorder","OK") Spares.
Next PM due =last_done+frequency_days Preventive maintenance.
Overdue PM =IF(TODAY()>next_due,"Overdue","OK") PM status.
Job cost =material+labour_hours*rate+overhead Cost sheet.
Rejection % =rejected/produced Quality.

How

  1. Open the Formulas used sheet inside each template.
  2. Change only yellow cells.
  3. Watch green cells recalculate.

3. BOM and job card

Why

Without a BOM, stores issue the wrong parts. Without a job card, nobody knows which machine is busy.

What

A multi-level-style BOM (parent–child rows) and a job card list.

How

  1. Download mechanical-bom-jobcard-cost.xlsx › BOM.
  2. Required qty = Order qty × Qty per × (1+Scrap%).
  3. Open Job cards; filter Status = Open.
  4. Change Order qty in yellow; required qty recalculates.
Daily output

Figure. Daily output with efficiency % = Actual ÷ Plan.

4. Production output, scrap and job cost

Why

Plan vs actual shows efficiency. Scrap reasons show quality. Cost sheet shows if the job made money.

What

Daily output log, scrap register and a job cost sheet.

How

  1. Open mechanical-production-scrap.xlsx.
  2. Efficiency % = Actual ÷ Plan (green).
  3. On Scrap, use Rejection % = Rejected ÷ Produced.
  4. On Cost sheet, Total = Material + Labour + Overhead.
PM schedule

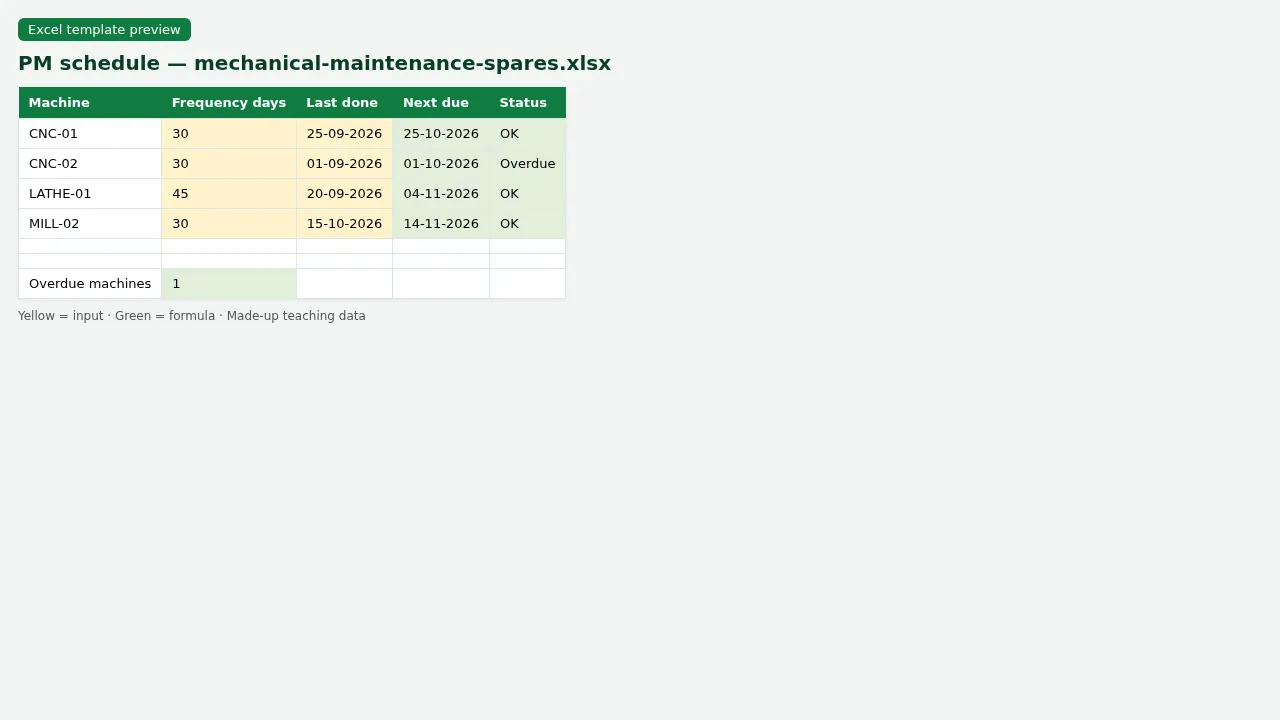

Figure. Preventive maintenance — next due and overdue flag.

5. Maintenance, spares and tool crib

Why

Breakdowns stop output. Spares and tools must be in stock and returned on time.

What

Breakdown log, preventive schedule, spare inventory and tool issue register.

How

  1. Open mechanical-maintenance-spares.xlsx › PM schedule.
  2. Next due = Last done + Frequency days; Overdue uses TODAY().
  3. On Spares, Reorder when Stock <= Min.
  4. On Tool crib, filter Return date blank for tools still out.
Vendor RFQ

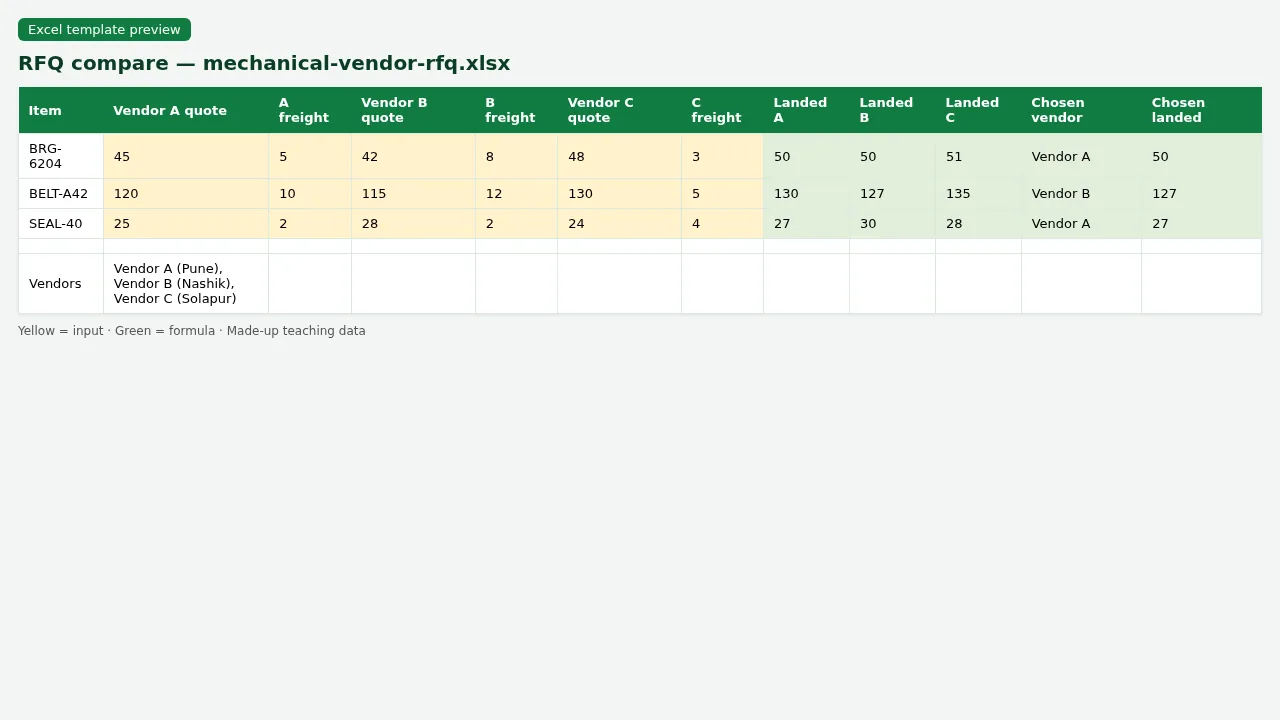

Figure. Vendor RFQ compare — lowest landed wins.

6. Vendor RFQ compare

Why

Buying teams compare quotes. Lowest price is not always best if lead time is long.

What

A simple RFQ sheet with three vendors and a Choose formula.

How

  1. Open mechanical-vendor-rfq.xlsx.
  2. Landed = Quote + Freight.
  3. Choose = vendor with lowest landed (teaching INDEX/MATCH).
  4. Yellow = quotes you type; green = choice.

7. Sheet previews

Why

See the layout before you open Excel.

What

Screenshots of the main sheets in the downloadable templates.

How

Scroll the figures, then download the matching .xlsx.

BOM sheet

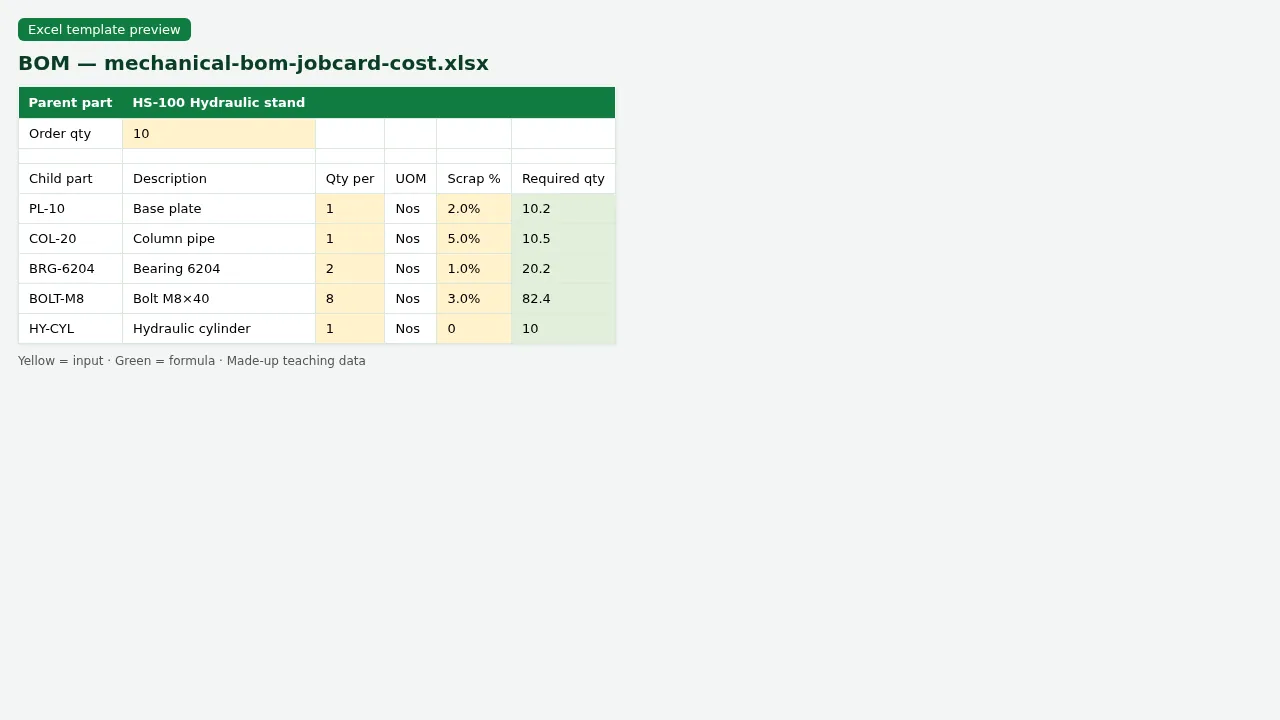

Figure. BOM with required qty including scrap %.

Daily output

Figure. Daily output with efficiency % = Actual ÷ Plan.

PM schedule

Figure. Preventive maintenance — next due and overdue flag.

Vendor RFQ

Figure. Vendor RFQ compare — lowest landed wins.

8. Common mistakes

Mistake What goes wrong Fix
BOM qty as text Required qty will not calculate. Use numbers; UOM in its own column.
Plan and actual on different rows without job no Cannot match efficiency. One row per job/shift with both plan and actual.
PM next due typed by hand Schedule drifts. Use Last done + Frequency days.
Negative stock allowed without flag Shop issues parts you do not have. Reorder flag when Stock <= Min.
Mixing tool issues into spare stock Both lists become wrong. Separate sheets.

9. FAQ

Is this a full ERP?

No. These are teaching templates for workshops and small plants that still run Excel.

What is BOM?

Bill of Materials — the list of parts and quantities needed to build one parent item.

What is a job card?

A work order: which part, how many, on which machine, by whom, start and finish.

How is downtime counted?

Finish time minus start time of the breakdown, in hours.

Are scrap % and overhead % industry standards?

No. They are made-up teaching values. Use your plant’s standards.

10. Try at home

Try at home

  1. On BOM, for parent HS-100 and order qty 10, what is required qty of the child with 5% scrap?
  2. On Daily output, what is efficiency for Shift A on the sample day?
  3. On PM schedule, how many machines are Overdue?
  4. On RFQ, which vendor is chosen for item BRG-6204?

Recap

In short

  1. 6 roles use Excel in this industry.
  2. 10 common file types are listed above.
  3. 4 downloadable templates with yellow inputs and green formulas.
  4. Rates and rules here are teaching examples only.
  5. Use Related chapters for focused skills (EDATE, KPIs, planning).

Quick revision cards

Quick revision

1 interview card, 1 comparison card and 1 revision card. Save on your phone or download as PNG. Numbers are made up for practice.

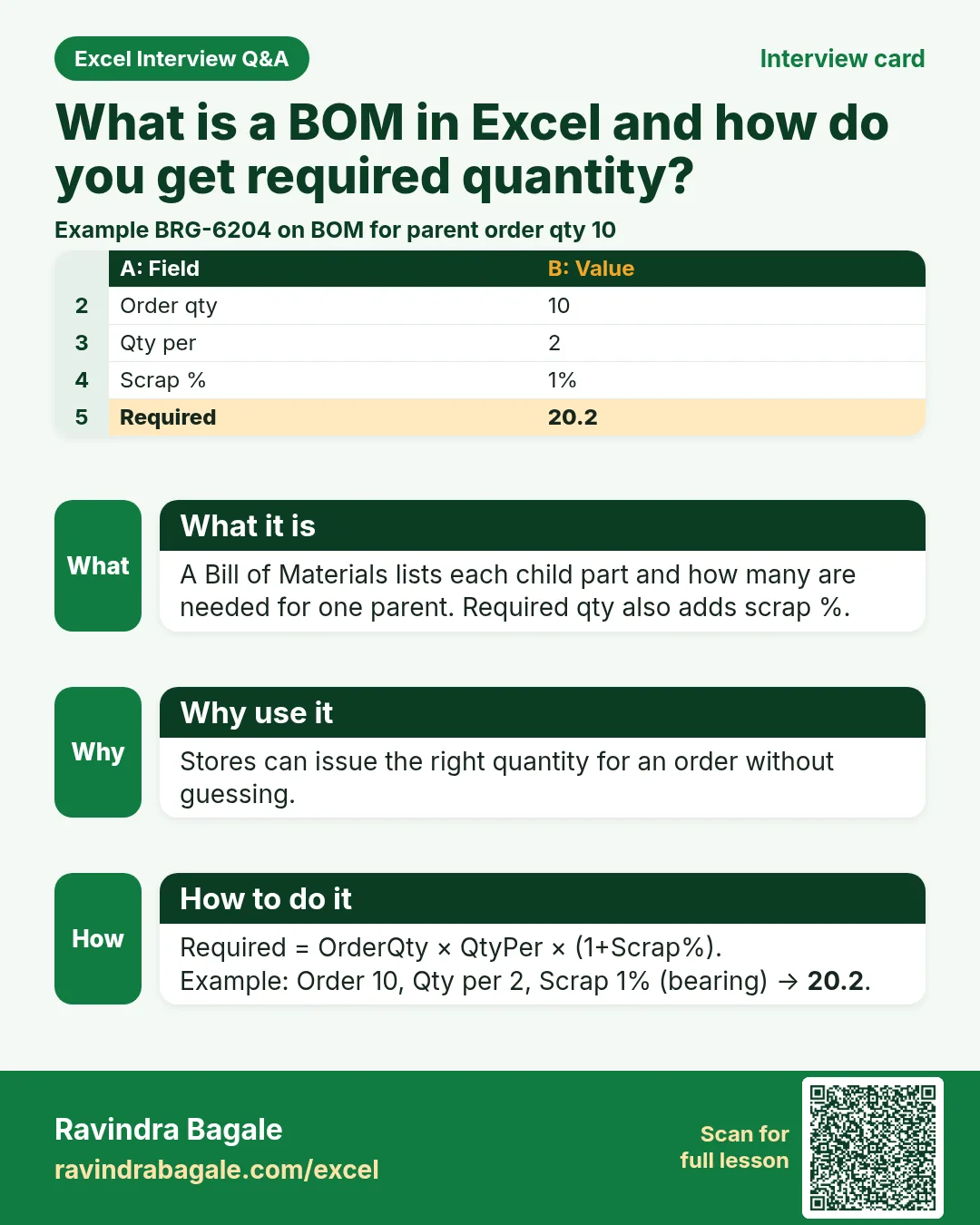

Interview card: What is a BOM in Excel and how do you get required quantity?
Card 1 of 3: Interview card – What is a BOM in Excel and how do you get required quantity? · Download PNG

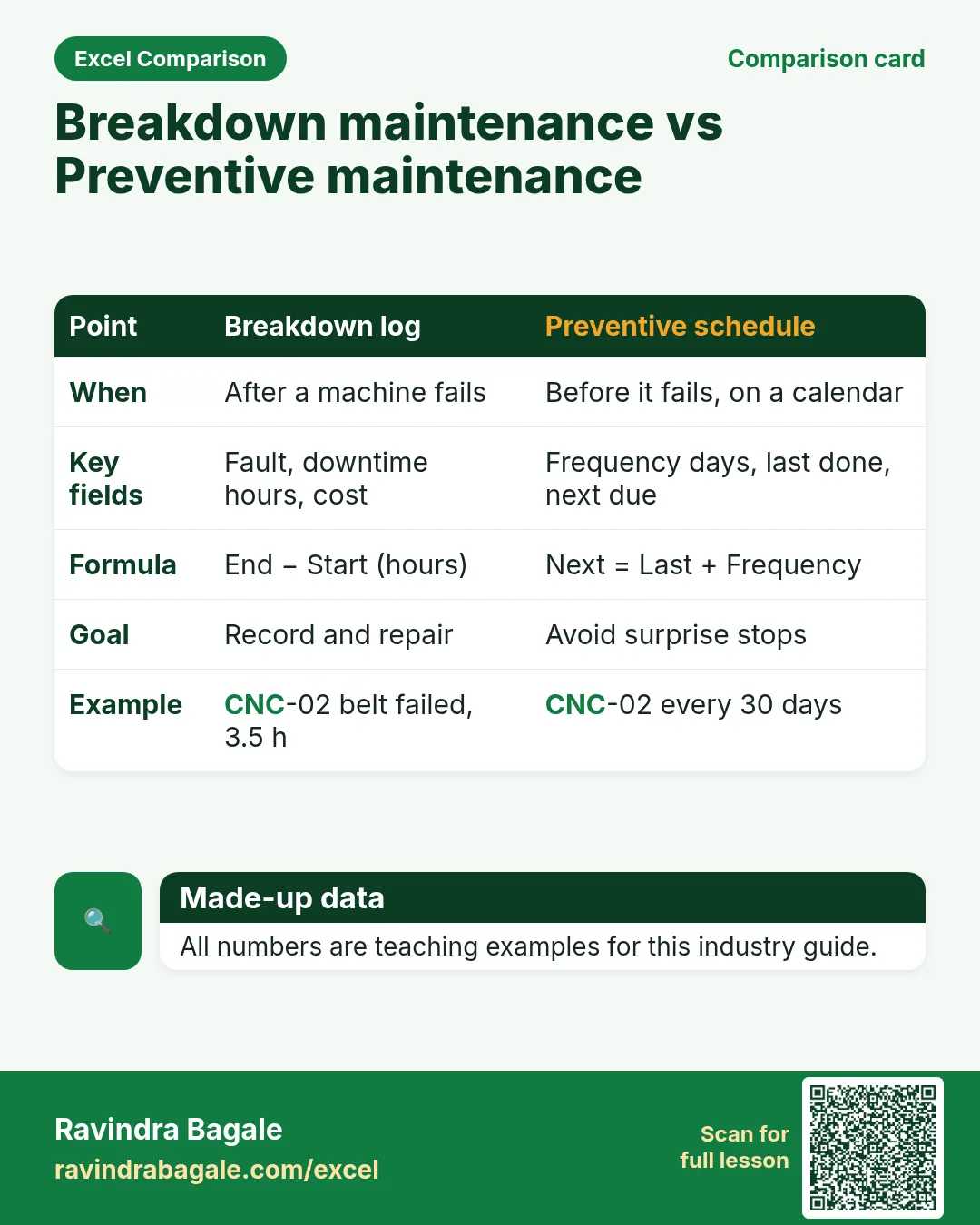

Comparison card: Breakdown maintenance vs Preventive maintenance
Card 2 of 3: Comparison card – Breakdown maintenance vs Preventive maintenance · Download PNG

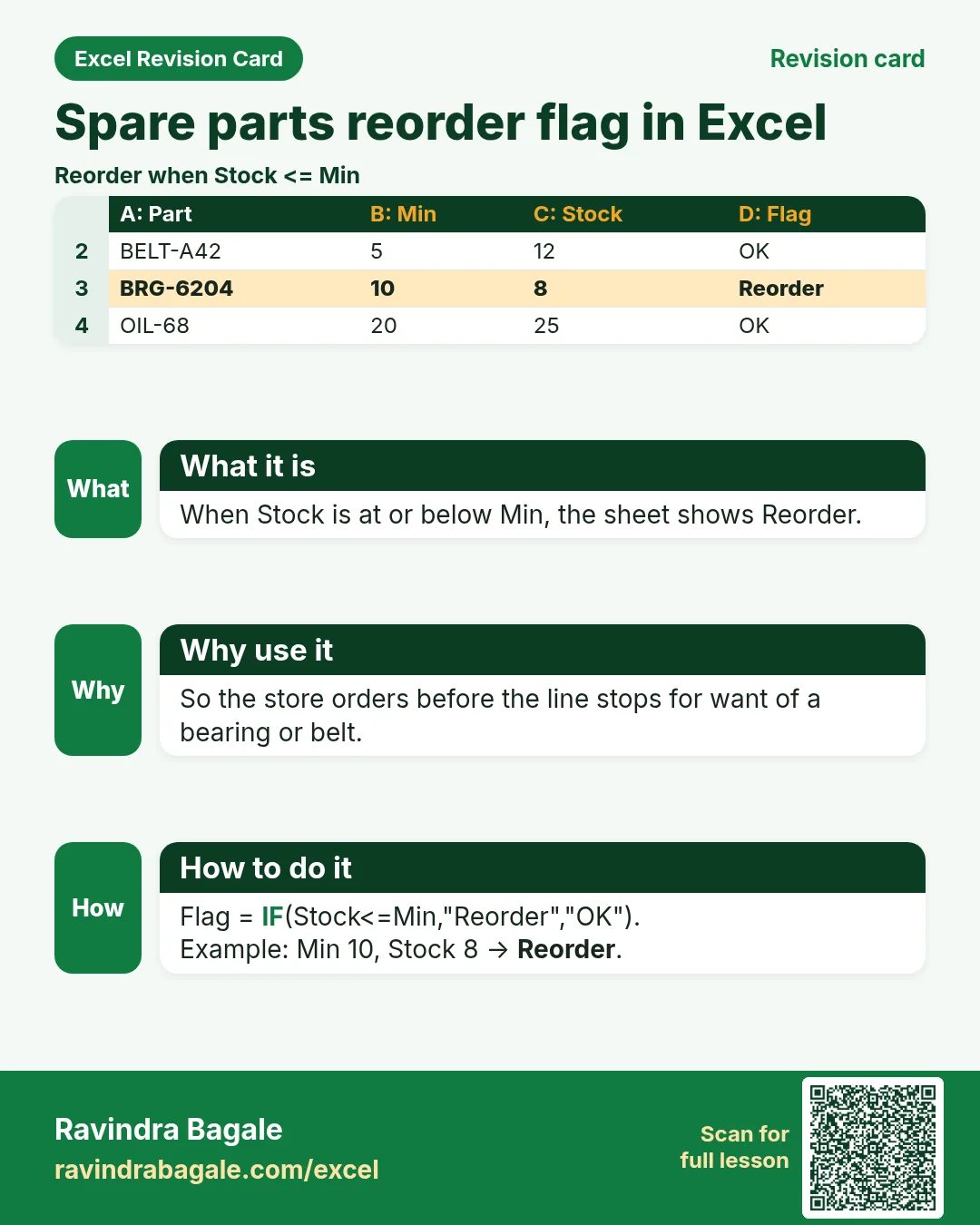

Revision card: Spare parts reorder flag in Excel
Card 3 of 3: Revision card – Spare parts reorder flag in Excel · Download PNG
