Ravindra BagaleCourses & study guides मराठी Track your progress

Mobile Repair Job Card System in Excel: Jobs, Parts Stock, Status Flags, Warranty and Dashboard

← All Excel dashboards

Salman Mobile Care in Pune repairs phones and tablets with two technicians. Phones sat on the shelf for days after repair because nobody called the owner, and parts ran out in the middle of a job. This page builds a 7-sheet Excel system: each phone gets a job card row with its part, charge, promised date and warranty, the parts sheet counts what is used, and the dashboard shows what is late or waiting to be collected.

What you'll learn on this page

  • Number job cards automatically
  • Price the part with a mark-up on cost
  • Work out balance, promised date and warranty date
  • Flag Overdue and Ready, not collected jobs
  • Count parts used and flag reorder
  • Report jobs, average days and part profit per technician
  • Print a job receipt for the customer

Download the template: mobile-repair-job-card-system-template.xlsx: a 7-sheet system with example data and real formulas (Read me, Setup, Parts, Jobs, Report, Job receipt, Dashboard). Yellow cells are inputs you can type over; green cells hold formulas; blue rows are headers and totals. Replace the example data with your own and every report and the dashboard recalculate.

Made-up data: every name, amount, business and date on this page is made up for practice. Cities are used only to make the examples feel real.

1. The business story

Salman Mobile Care, Pune, 1 to 17 October 2026 (made-up data). 30% mark-up on part cost, 2-day standard promise, 30-day repair warranty. Technicians Salman and Amir.

Question Where the system answers it
Which phone is late? J-010, Raja Kale, waiting for a screen since 14 October
Which phone is ready but not picked up? J-009, Ruhi Pawar, ₹1,095 to collect
How fast are we? Dashboard: 1.7 days on average for delivered jobs
Which part to order? Parts: Screen 6.5 in, 1 left against a level of 2

13 jobs brought ₹14,339; 9 are delivered. Amir handled 7 jobs, Salman 6.

Setup Mark-up on part cost Standard promise days Warranty days Technicians, statuses Entry Parts: cost, opening Jobs: customer, fault, part, status Calculations Part charge, total Balance Promised, flag Warranty till Outputs Job receipt Technician report KPI cards Charts

Figure 1. Setup and Parts hold rules and stock; Jobs is the only entry sheet; the rest reads from it.

2. Build it sheet by sheet

Step 1. Setup and Parts

  1. Setup B4 mark-up (30%), B5 standard promise (2 days), B6 warranty (30 days); lists of technicians and statuses in D and E.
  2. Parts: Code, Part, Cost, Opening, Reorder level. Code P00 means no part (software work, checks).

Step 2. Jobs: charges and dates

  1. A5 ="J-"&TEXT(ROW()-4,"000"). Type date, customer, device, fault and pick a part code.
  2. G5 part charge =ROUND(XLOOKUP(F5,Parts!$A$5:$A$10,Parts!$C$5:$C$10,0)*(1+Setup!$B$4),0): a ₹1,800 screen is charged ₹2,340.
  3. I5 total =G5+H5, K5 balance =IF(O5<>"",0,I5-J5), N5 promised =B5+Setup!$B$5.
  4. R5 warranty till =IF(O5<>"",O5+Setup!$B$6,""), counted from the delivery date.

Step 3. Jobs: flags

  1. P5: =IF(O5<>"","Delivered",IF(M5="Ready","Ready, not collected",IF(N5<Setup!$B$3,"Overdue","On track"))).
  2. Q5 days taken for delivered jobs =IF(O5<>"",O5-B5,"").
  3. Colour Overdue red and Ready, not collected amber with conditional formatting; call those customers first.

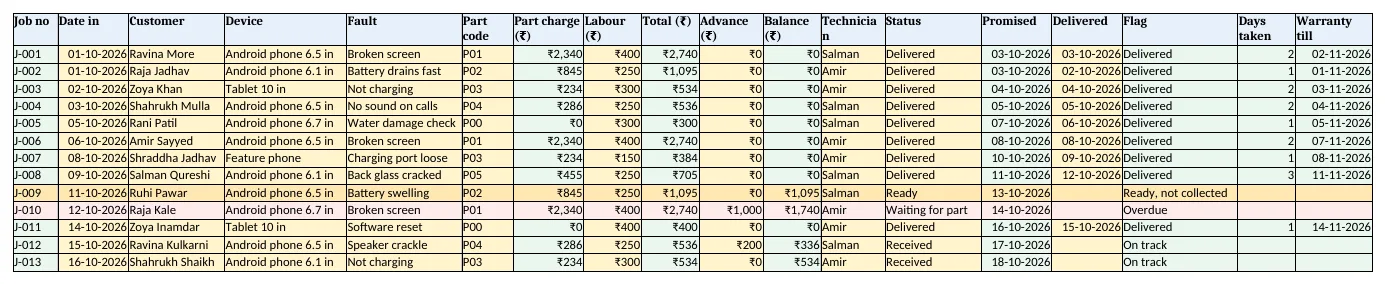

Jobs: charges, balance, promised date, flag, days taken and warranty

Figure 2. Jobs: charges, balance, promised date, flag, days taken and warranty

Step 4. Parts stock and Report

  1. Parts F5 used =COUNTIF(Jobs!$F$5:$F$500,A5), G5 closing =D5-F5, H5 order =IF(A5="P00","-",IF(G5<=E5,"Yes","No")).
  2. Report B5 jobs per technician, C5 delivered with COUNTIFS, E5 average days with AVERAGEIFS and F5 revenue.
  3. G5 profit on parts: part charges minus part cost for that technician's jobs.

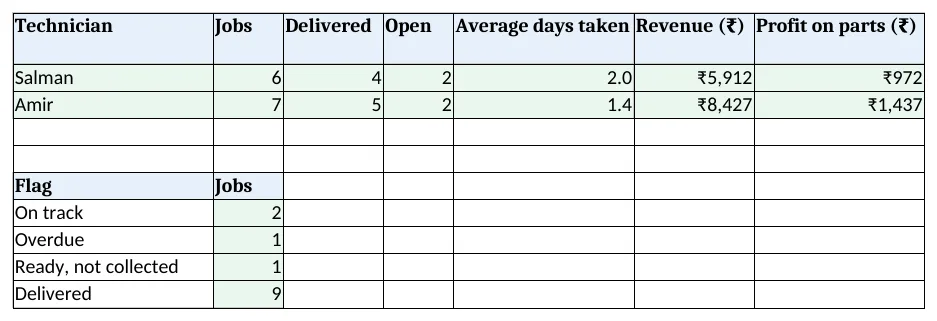

Report: jobs, delivered, average days and part profit per technician, and jobs by flag

Figure 3. Report: jobs, delivered, average days and part profit per technician, and jobs by flag

Step 5. Job receipt and Dashboard

  1. Job receipt: type a job no in B4; rows 6 to 14 bring customer, device, fault, total, advance, balance, promised date and status. The footer reminds the customer to back up data.
  2. KPI cards: jobs, open, overdue, average days =AVERAGE(Jobs!$Q$5:$Q$500), revenue and parts to order. Charts: jobs by flag and revenue by technician.

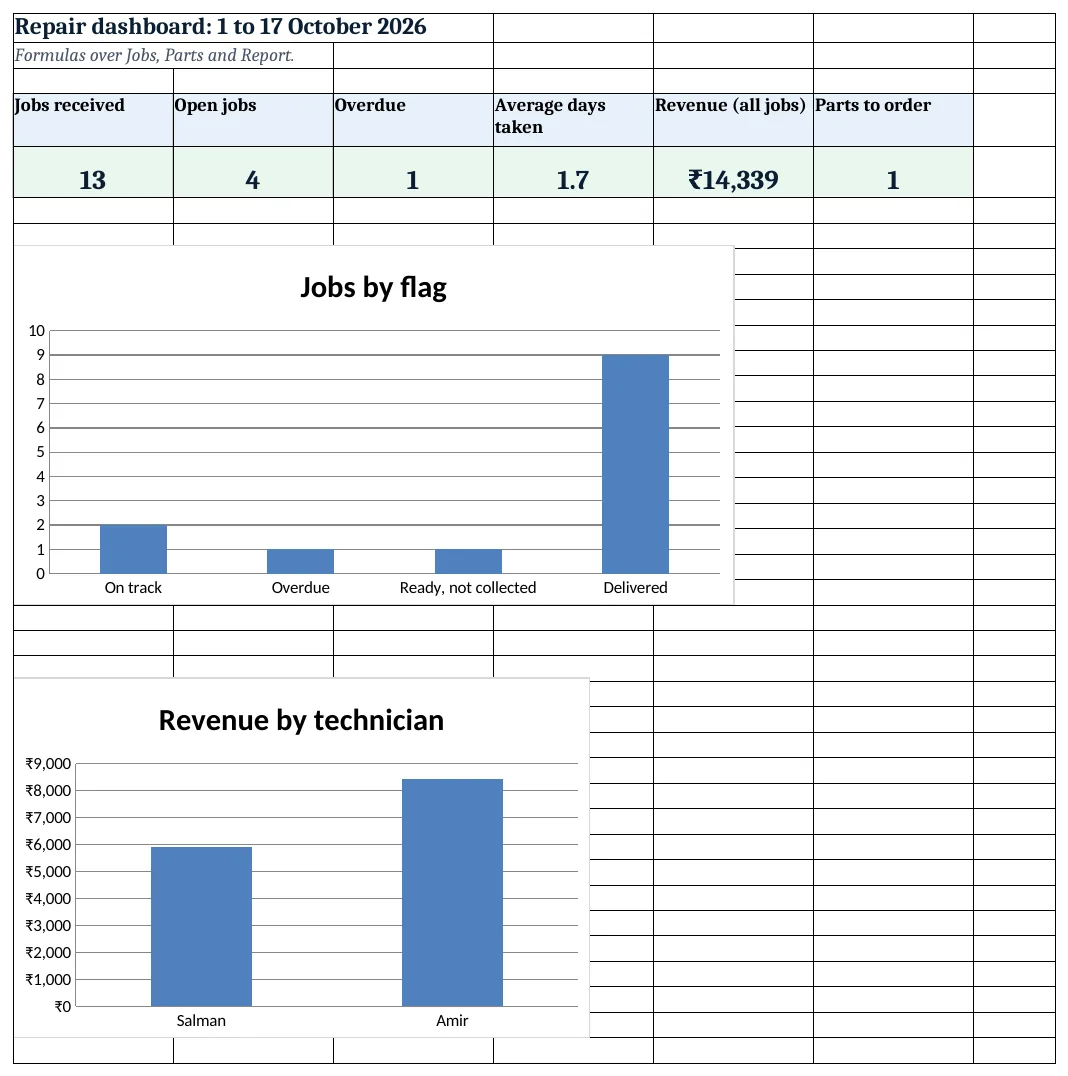

Mobile repair dashboard: jobs, open, overdue, average days, revenue and parts to order

Figure 4. Mobile repair dashboard: jobs, open, overdue, average days, revenue and parts to order

Ravindra Bagale's Tip

Phone every Ready, not collected customer the same evening. A repaired phone on the shelf is money you have earned but not received.

3. Formulas used

Cell Formula What it does
Jobs!A5 ="J-"&TEXT(ROW()-4,"000") Automatic job number
Jobs!G5 =ROUND(XLOOKUP(F5,Parts!$A$5:$A$10,Parts!$C$5:$C$10,0)*(1+Setup!$B$4),0) Part charge with mark-up
Jobs!I5 =G5+H5 Job total
Jobs!K5 =IF(O5<>"",0,I5-J5) Balance to collect
Jobs!N5 =B5+Setup!$B$5 Promised date
Jobs!P5 =IF(O5<>"","Delivered",IF(M5="Ready","Ready, not collected",IF(N5<Setup!$B$3,"Overdue","On track"))) Status flag
Jobs!Q5 =IF(O5<>"",O5-B5,"") Days taken
Jobs!R5 =IF(O5<>"",O5+Setup!$B$6,"") Warranty till
Parts!F5 =COUNTIF(Jobs!$F$5:$F$500,A5) Parts used
Parts!H5 =IF(A5="P00","-",IF(G5<=E5,"Yes","No")) Order this part?
Report!E5 =IFERROR(AVERAGEIFS(Jobs!$Q$5:$Q$500,Jobs!$L$5:$L$500,A5,Jobs!$P$5:$P$500,"Delivered"),0) Average days per technician
Job receipt!B6 =XLOOKUP($B$4,Jobs!$A$5:$A$500,Jobs!$B$5:$B$500,"Not found") Date the phone came in
Dashboard!D5 =AVERAGE(Jobs!$Q$5:$Q$500) Average days taken

Every formula above is written in the template, so you can click a cell and see it in the formula bar. All values on this page were recalculated in LibreOffice with zero errors.

4. Common mistakes

  1. Warranty from the date in. Count warranty from the delivery date, or the customer loses days the phone sat in the shop.
  2. No row for checks and software work. Use part code P00 so the job, labour and technician still count.
  3. Status left at Received. Change it to Waiting for part or Ready as soon as it changes; the flags depend on it.
  4. Balance kept after delivery. K5 drops to 0 on delivery, so collect before typing the delivered date.
  5. Mark-up typed into each charge. Keep the mark-up on Setup; changing one cell then reprices new jobs consistently.

Ravindra Bagale's Tip

Take an advance when a part has to be ordered. J-010 had ₹1,000 advance, so the shop is covered if the customer changes their mind.

5. More real examples

Example 1: Laptop repair. Add a Serial no column and a longer standard promise (5 days).

Example 2: Electronics service centre. Add an In warranty? column and charge ₹0 when the date is within the maker's warranty.

Example 3: Watch and clock repair. Same layout with batteries, straps and glass as parts.

Quick revision cards

Quick revision

Each card shows formulas from this page, each with an example and its answer from the template. Scan the QR code on a card to open this lesson. All names and numbers are made up for practice.

Revision card 1 for Mobile Repair Job Card System in Excel: Job total: =G5+H5 gives ₹2,740; Automatic job number: ="J-"&TEXT(ROW()-4,"000") gives J-001; Promised date: =B5+Setup!$B$5 gives 03-10-2026. Includes an example data table.
Card 1 of 2: Mobile Repair Job Card System in Excel · Download PNG
Revision card 2 for Mobile Repair Job Card System in Excel: Days taken: =IF(O5<>"",O5-B5,"") gives 2; Warranty till: =IF(O5<>"",O5+Setup!$B$6,"") gives 02-11-2026; Parts used: =COUNTIF(Jobs!$F$5:$F$500,A5) gives 3. Includes an example data table.
Card 2 of 2: Mobile Repair Job Card System in Excel · Download PNG

More cards: Ravi Sir's Cards.

6. Frequently asked questions

How do I make a job card number in Excel?

="J-"&TEXT(ROW()-4,"000") in row 5 gives J-001 and counts up row by row.

How do I add a mark-up to a part cost?

Cost × (1 + mark-up), rounded: =ROUND(cost*(1+Setup!$B$4),0).

How do I show phones ready but not collected?

Check the status first: if it is Ready and no delivery date is typed, show "Ready, not collected".

How do I work out a warranty end date?

Delivery date + warranty days, as in Jobs R5.

How do I find average repair time per technician?

AVERAGEIFS on the days-taken column with the technician and Delivered as conditions.

7. Quick quiz

Ten questions on this page. Sign in to save your score.

Loading practice tasks...

  1. Pass or fail (Easy): "Pass" if B2 is at least 40, else "Fail". (sheet "Scores")
  2. Total (Easy): B2 plus C2. (sheet "Scores")
  3. Passed score 1 (Easy): How many in B2:B11 are 40 or more? (sheet "Scores")
  4. Days taken (Easy): C2 minus B2. (sheet "Dates")
  5. Start year (Easy): Year of B3. (sheet "Dates")
  6. Due month (Easy): Month number of C3. (sheet "Dates")
  7. Earliest start (Easy): Earliest date in B2:B9 (as a date number). (sheet "Dates")
  8. Passed both (Medium): TRUE if B3 and C3 are both at least 40. (sheet "Scores")
  9. Passed either (Medium): TRUE if B4 or C4 is at least 75. (sheet "Scores")
  10. Grade (Medium): Grade for the average of B2:C2: "A" 75+, "B" 60+, "C" 40+, else "F". (sheet "Scores")
  11. Working days (Medium): Working days from B2 to C2. (sheet "Dates")
  12. Weekday of due (Medium): Weekday number of C4 (Sunday = 1). (sheet "Dates")
