Excel for Engineers and Project Managers: Cost Estimation, Planning and Tracking (With Templates)
This guide is for people in the engineers profession who use Excel every day. You will see every common file, the formulas people actually type, and downloadable templates with made-up Indian ₹ data. Related short lessons are linked — we do not re-teach them here.
What you'll learn
- Which roles use Excel in engineers
- Every common Excel file type for this profession
- Sample tables with realistic ₹ examples (made-up names)
- Formulas: Line amount, With contingency, Delay days, Cost variance and more
- Ready templates you can download and reuse
Downloads: engineers-pm-cost-tracker.xlsx (BOQ estimate + WBS tracker + plan vs actual + cost tracking + CR log)
Example data only
All names, amounts, rates and dates are made up for practice. They are not real client or employer records. Follow your organisation's own rules and software for live work.
In short
One profession → many Excel files. Each file is one clear list. Yellow cells are inputs; green cells are formulas. Start with the Roles table, then open the matching template.
थोडक्यात
एक profession → अनेक Excel files. प्रत्येक file = एक स्पष्ट यादी. Yellow = input; green = formula. Roles table पासून सुरू करा, नंतर matching template उघडा.
संक्षेप में
एक profession → कई Excel files. हर file = एक साफ सूची. Yellow = input; green = formula. Roles table से शुरू करें, फिर matching template खोलें.
Related chapters (already on this site)
Why
Some topics already have a focused lesson. Use those for depth; use this guide for the full profession picture.
What
| Chapter | What it covers |
|---|---|
| Excel for Mechanical (industry) | BOM, job card, maintenance, RFQ. |
| Manufacturing production planning | Capacity and finish date. |
| Excel for Manufacturing (industry) | Plant-wide production and OEE. |
How
- Skim the link if you need that one skill.
- Come back here for the full file list and templates.
1. Who uses Excel
Why
This page is project control. For BOM, job card and spares use Mechanical / Manufacturing industry guides.
What
| Role | Typical Excel work |
|---|---|
| Design / project engineer | BOQ lines, estimates, revisions. |
| Project manager | Plan vs actual dates, % complete. |
| Site engineer | Daily progress qty, issues log. |
| Costing engineer | Budget vs committed vs actual cost. |
How
- Open Excel for Mechanical for BOM and maintenance.
- Open Excel for Manufacturing for OEE and production.
- Download engineers-pm-cost-tracker.xlsx for project sheets.
2. Every common Excel file
Why
If you only learn one dashboard, you miss the daily registers that feed it.
What
| File | What one row / sheet holds |
|---|---|
| Cost estimate / BOQ | Item, qty, rate, amount, contingency %. |
| WBS task tracker | Task, owner, start, finish, % complete, status. |
| Plan vs actual dates | Baseline finish, actual finish, delay days. |
| Cost tracking | Budget, committed, actual, variance. |
| Issues / CR log | Change request, impact ₹, decision. |
How
- Pick the file that matches your role.
- Download the template that contains that sheet.
- Replace yellow sample rows with your practice data (still made-up if you share screenshots).
3. Formulas people use
Why
Typed numbers go stale. Formulas update when inputs change.
What
| Name | Formula | What it does |
|---|---|---|
| Line amount | =qty*rate |
BOQ line. |
| With contingency | =amount*(1+cont%) |
Buffer. |
| Delay days | =actual_finish-baseline_finish |
Slippage. |
| Cost variance | =actual-budget |
Overrun signal. |
| EV teaching | =budget*%_complete |
Simple earned value proxy. |
| SPI teaching | =EV/PV |
Schedule performance proxy. |
How
- Open the Formulas used sheet inside each template.
- Change only yellow cells.
- Watch green cells recalculate.
3. Estimate and WBS
Why
A project without a WBS is a wish.
What
BOQ with contingency; task tracker with % complete.
How
- Enter qty and rate (yellow); Amount green.
- Update % complete; Status uses thresholds.
- Sum Contingency-included total at bottom.

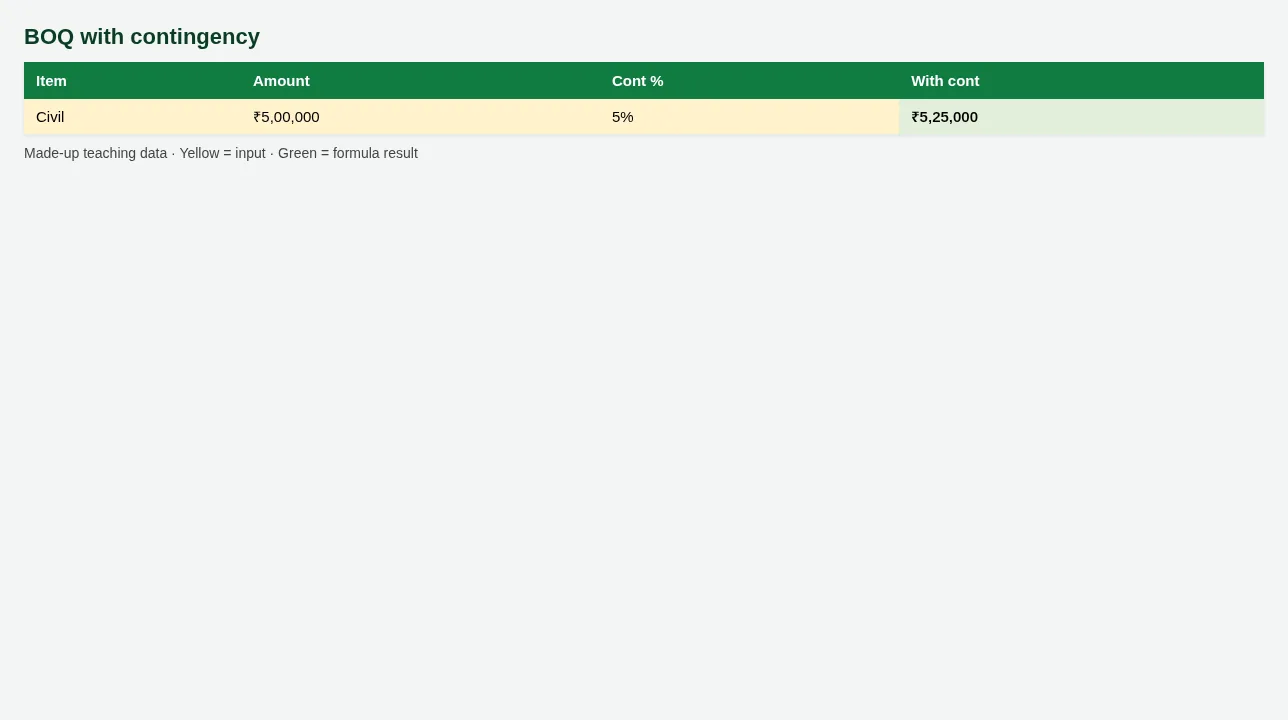

Figure. BOQ with contingency
4. Dates and cost tracking
Why
Late and over-budget must show as numbers.
What
Delay days and cost variance sheets.
How
- Delay days = Actual finish − Baseline.
- Cost variance = Actual − Budget.
- EV teaching = Budget × % complete (simple classroom proxy, not full EVM).
5. Sheet previews
Why
See the layout before you open Excel.
What
Screenshots of the main sheets in the downloadable templates.
How
Scroll the figures, then download the matching .xlsx.

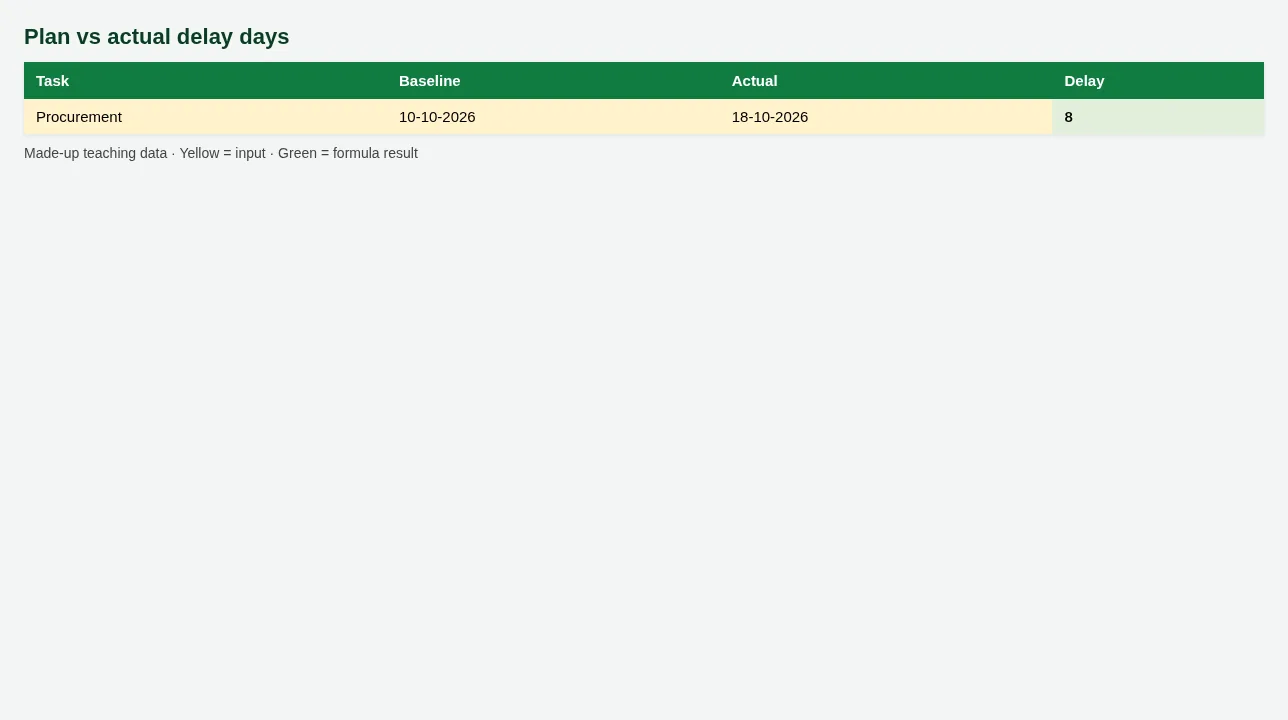

Figure. Plan vs actual delay days

Figure. BOQ with contingency
6. Common mistakes
| Mistake | What goes wrong | Fix |
|---|---|---|
| % complete as gut feel only | EV becomes fiction. | Tie % to measurable qty when you can. |
| Ignoring Mechanical templates | Plant jobs miss BOM scrap %. | Use industry guides for shop-floor files. |
7. FAQ
Is this full earned value management?
No — teaching proxies only. Real EVM needs PV, EV, AC standards.
8. Try at home
Try at home
- Total estimate with contingency?
- Which tasks show Status = Late?
- Cost variance on package PKG2?
Recap
In short
- 4 roles use Excel in this profession.
- 5 common file types are listed above.
- 1 downloadable templates with yellow inputs and green formulas.
- Rates and rules here are teaching examples only.
- Use Related chapters for focused skills.
Quick revision cards
Quick revision

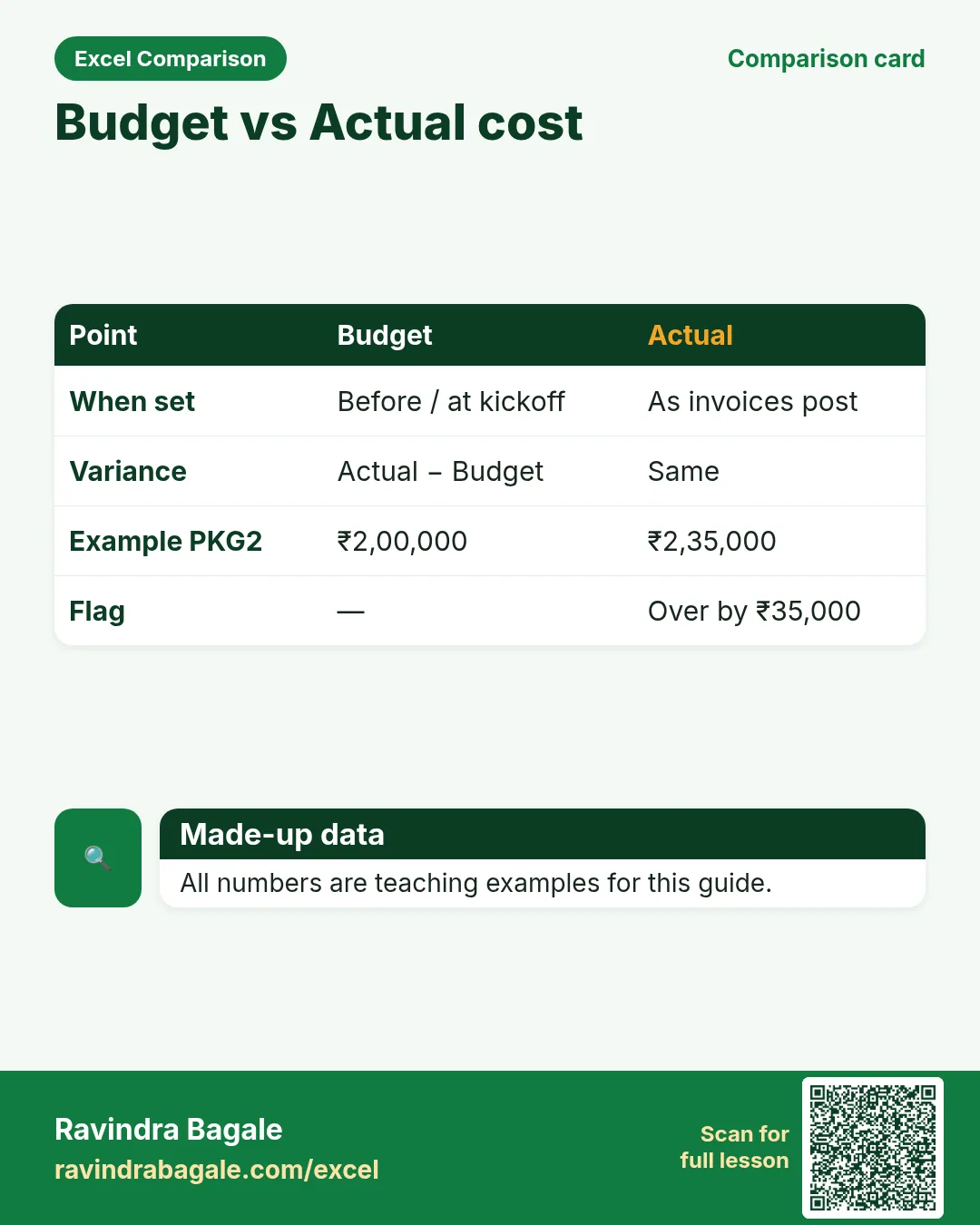

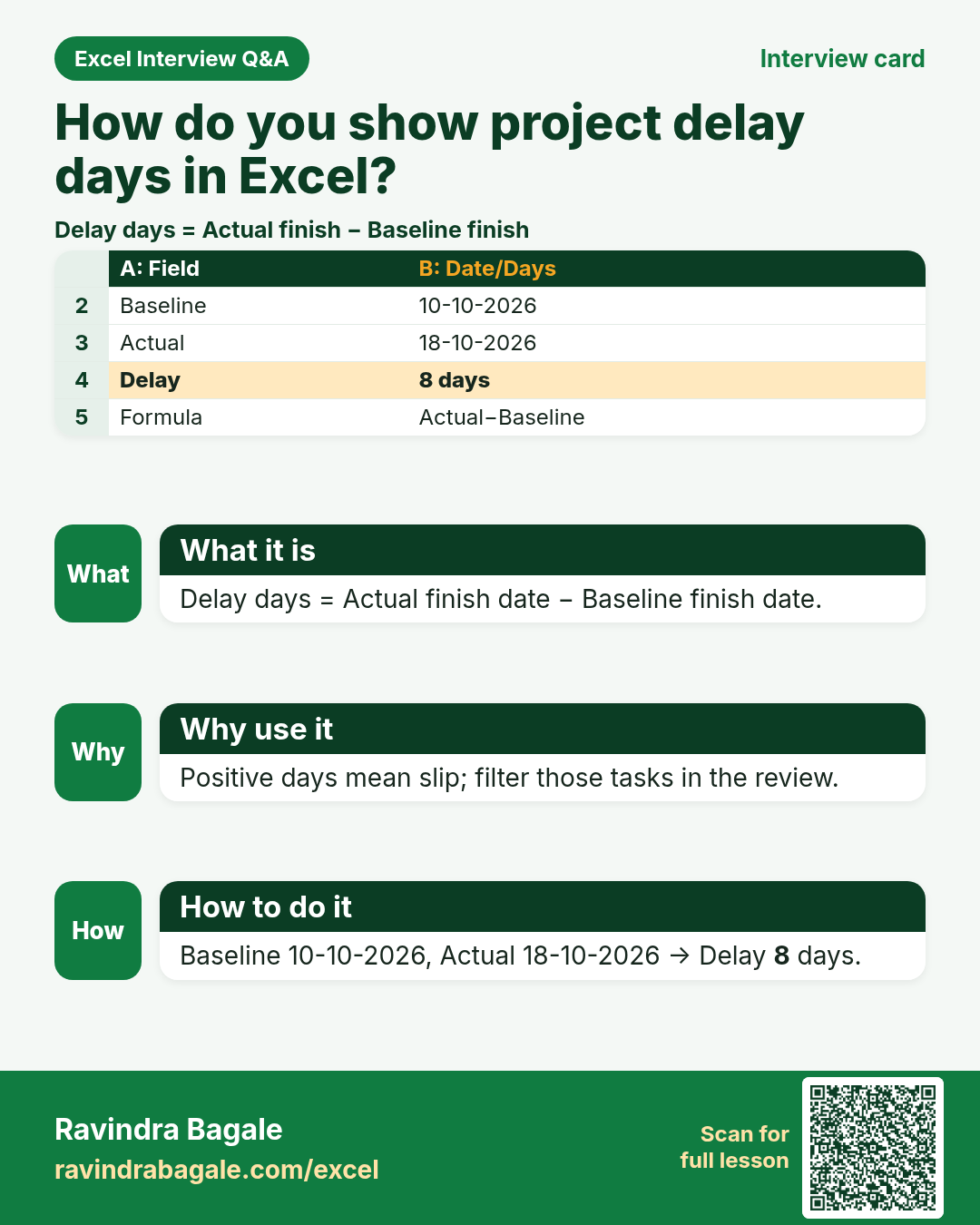

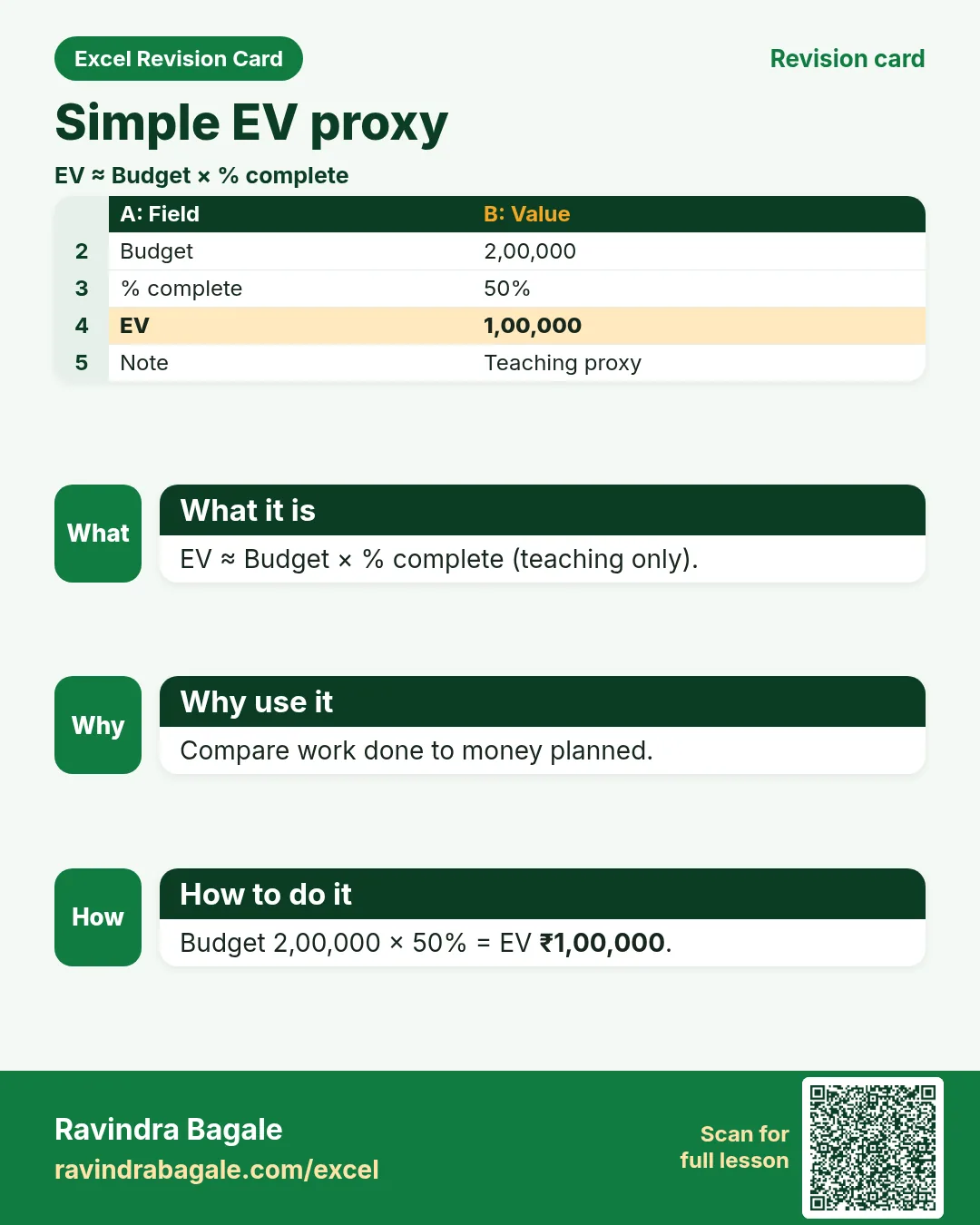

1 interview card, 1 comparison card and 1 revision card. Save on your phone or download as PNG. Numbers are made up for practice.
झटपट उजळणी
1 interview card, 1 comparison card आणि 1 revision card. Phone वर save करा किंवा PNG download करा. आकडे सरावासाठी काल्पनिक आहेत.
झटपट दोहराई
1 interview card, 1 comparison card और 1 revision card. Phone पर save करें या PNG download करें. आंकड़े अभ्यास के लिए काल्पनिक हैं.
